WORKING WITH RESOURCES
Simple Resources
Adding new resources into an Estimate is simply done by:
- Typing the RC (Resource
Code) into the RC column, then pressing the 'CTRL+' key
combination. A dialog will appear as below where the details
of the new resource can be entered

NOTE: The number of fields to be filled will depend on the
columns that exist in the Project's Resource Library, and
their properties.
The columns shown in this dialog must:
- Exist in the local library
- Not be hidden
- Not be protected
- Not have a Formula
If there are columns other than the mandatory columns , common
in both this Worksheet and the Resource Library, then the data
in these common columns in this Worksheet are also added into
the Resource Library.
The same process takes place when you import data, either
through Lookup Tables, Copy/Paste, Clipfile Imports, etc, into a
Worksheet. All resources that exist in the imported data will
automatically be added to the Resource Library if they don't
exist. Note though, the details added to the Resource Library
for each new resource, will be the details for the first
occurrence of that new resource in the imported data.
If this Project maintains foreign currencies, AND the
Preferences option 'Ignore Confirm New Resources' is OFF, then a
Dialog will appear with appropriate fields already filled in
(the CURR/N, and PURCH/P will be filled in with the defaults
already). Make any changes then accept if appropriate.
Composite Resources
The same process is followed for Composite Resources as is for
Simple Resources. The only difference is that with Composites,
you will double click in the Rate column and build up the rate
within a Rate Workup sheet.
Once this composite gets transferred to the local Library, the
RATE workup sheet will be replaced with the literal rate value.
Subsequent editing of the Rate workup will then have to be done
from within the Resource Library.
USING RESOURCES
Generally
Using resources is only possible if the worksheet
contains the 'RC' and 'CC' columns. These sheets are
normally a RATE or COST worksheet.
When you open up one of these worksheets, the default view is:

The left panel shows the list of available resources, and the
right panel is the RATE/COST worksheet details.
You 'call up' a resource by either:
- Double clicking on the resource you want in the left panel
(RC List Panel)
The chosen resource details will then fill out in the
worksheet (right panel)
- Typing the RC in the RC column in the RATE/COST worksheet
As you type 'text' into the RC column, the left panel
contents will be instantly abbreviated to show ONLY those
resources that match the 'text' in either the RC or
DESCRIPTION columns of the RC List Panel
Spring Loaded RC List Panel
On some computers, especially laptops, which have
limited screen sizes, it is preferable to not show the RC List
Panel at all times.
The option in System Preferences, displayed below, if ON will
keep the RC LIst Panel 'closed' until you start typing into the
RC column of the worksheet when it will automatically spring
open displaying the resources. When you are finished typing or
selecting the RC, the RC List Panel will automatically close.
RESOURCES FROM AN
EXTERNAL LIBRARY
You can nominate another Project as being the source of Resource
details (
External Library) . That is, if you
enter a Resource Code into the RC column of a worksheet, and
that resource does not exist in the current Project, it will
look for it in this
External Library. If this
External Library does contain this resource, the program will
automatically import and add it into the current Project.
Furthermore, if you do not have the
'Defaults->Preferences->Do not confirm New Resources'
option ticked, then each time a resource is imported from an
external library, a dialog box will appear with the new
Resources details, waiting for you to modify if desired and then
click accept. Here is an example of this dialog:
As you can see, this is a Table of Columns, the columns being
those that exist in the current Project's Resource Library,
filled in with the data in the corresponding columns of the
External Resource Library. You now can either press 'ENTER' to
accept the details as presented, or press the 'TAB' key to
activate the first and subsequent columns in this Table and make
changes before accepting.
Choosing the External Library
When a Project is first created, it sets the 'External
Library' pointer to itself.
Changing this pointer to another Project is achieved by opening

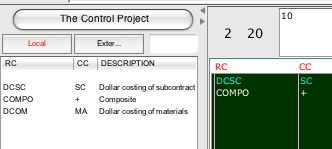

a RATE/COST workup sheet, and then clicking the button just
above the 'Local' and 'External' buttons in the Resource List
Panel on the left as depicted below:
Select the Project you want to
be your external library and it's name will now appear
in the button. This setting will be remembered until
changed.
MODIFYING EXISTING RESOURCES
Once a resource has been created and used, you can use one of
the three methods described below to change it's details:
-
Editing the Resource Library by
clicking 'Library' in the Edit TAB, then editing the
detail to be changed
-
Editing the resource details while in a
Rate/Cost Worksheet
Note however you are not permitted to change the 'CC', UNIT,
or 'RATE' fields of Composite resources via this method.
Editing the detail in this manner is achieved by:
- either
Pressing
CTRL+ALT+DownArrow on the resource code in the Worksheet
OR
Right-click on the
Resource code in the worksheet, and selecting the option
'Other->Edit Resource/Composite' from the popup menu
- Making the necessary modifications
- Clicking the ACCEPT button
-
- Editing/Viewing the build-up of a
composite
- Press CTRL+ALT+DownArrow on the 'resource code of the
Composite to be edited/viewed
- edit the details for the composite in the Rate Workup sheet
that is presented
- close the worksheet when finished
NOTE: In ALL the above cases, the Project must be
recalculated to align the modifications made with the details of
those resources that already exist in the body of the Estimate.
If
you want to find out where in the project you have used a
particular resource or text phrase:
- bring the 'Project Window' to the front
- click on the 'Edit' TAB
- click the
'Search' button

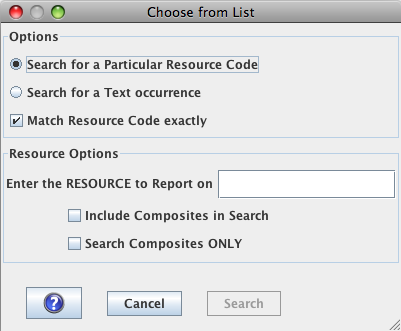

- the following dialog appears:
- click the option for '..Particular Resource..' or
'...Text..'
- Enter the resource code OR the text phrase you are
interested in
- If you are searching for a resource, Tick or UnTick the
'Match Resource code exactly'
- if you leave this option ticked, only resources with
the Exact code will be listed
- if unticked, then any resource containing the search
phrase will be listed
- click 'Search'
- after a few seconds (depending on the size of the
Project) a listing similar to the following appears:

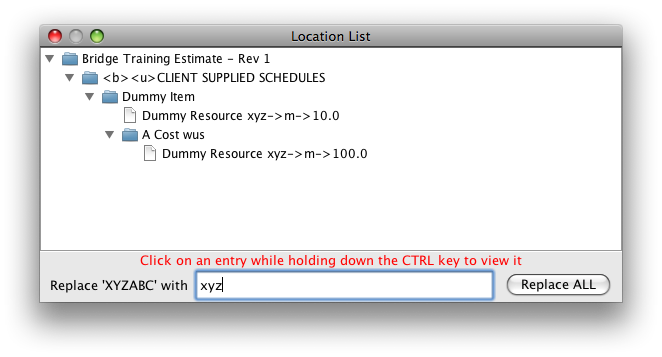

- this shows an expanded 'tree list' of the items
found in the project. Each entry found is listed with
the 'path through each worksheet' necessary to locate
the entry. In the above example, this shows there are
two entries in the Project for a resource 'XYZABC',
and it is located in Section 'CLIENT SUPPLIED
SCHEDULES' -> sub-item 'Dummy Item'
- CTRL+click on any entry, and the program will open
up all worksheets and sub-sheets necessary to locate
the entry. Furthermore, in each worksheet and
sub-sheet, the program will locate the entry for you
REPLACING A
RESOURCE CODE GLOBALLY IN THE PROJECT WITH A NEW
RESOURCE CODE
The following steps describe how to change an
existing resource code with a different resource code
throughout the Project.
- bring the 'Project Window' to the front
- click on the 'Edit' TAB
- click the
'Search' button
- the following dialog appears:
- click the option for '..Particular Resource..'
- Enter the resource code you are interested in
- click 'Search'
- after a few seconds (depending on the size of the Project) a
listing similar to the following appears:
- this shows an expanded 'tree list' of the items found in
the project.
- now type in the new resource code to replace the
existing
- click 'Replace ALL'
- clcik 'Yes' to confirm or 'No' to cancel the replacing
process
- if you clicked 'Yes' to the previous confirmation, you
will be asked to change the Resource in the Library as
well
You should do this
otherwise you will have resources in the estimate
without them being specified in the Libary
- a Message will come up when finished that ALL
occurrences have been replaced
- Done
REMOVING UNUSED
RESOURCES
Generally
An 'unused' resource is
defined as a resource which exists in the Library and/or in the
Estimate body but without a quantity.
In most scenarios this is caused by not 'building
up' the local Project Library, but rather starting off with a
Library already present in the Template from which this project
was copied, or by Copy/Paste into this project library from
another project library.
The following steps can be used to remove all unused
resources:
Sometimes
you may need to repeat this process again, as some resources
may have existed in Composites which have subsequently been
removed. Once all unused resources have been removed, a
message accordingly will appear.
Considerations
Where resources have been
entered into the body of the estimate, but have no aggregated
quantity, they will remain in the estimate but will have been
removed from the Library.
Consequently the next time a
Project->Recalculate is performed, these resources will be
listed in an error report as not existing.
It may be a situation where they have been entered
into the estimate but their quantity not measured. You can
quickly verify this by 'finding' where they have been used
through the 'Project->Search' option and investigating.
COST CATEGORIES:
Generally:
Cost
Categories (abbreviated as CC) are a coding system of two
letters which enables the program to break down the Total
Project Cost into up to seven different groups called Cost
Categories.
Typical CC's are :
LA - Labour (mandatory)
MA - Material (redefinable)
TM - Temporary Material (redefinable)
PE - Plant External (Hired) (redefinable)
PO - Plant Owned (redefinable)
SC - Subcontract (redefinable)
and Other (mandatory)
Reports with the options 'Detailed' and 'include
CC breakdowns' chosen will list in vertical columns, the cost of
each if included in either the resources used to price an item,
or directly entered into the 'CC' column of the priced items.
Any costs which have not got a CC definition will automatically
be added into the 'Other' column of the listing.
Clicking the 'MORE' button in the Project Window will provide a
dialog which enables you the user to redefine the default CC
codes and names for the project. NOTE: The LA - LABOUR cost
category is mandatory and cannot be changed.
Cost Category % Adjustments:
Each CC
(except OTHER) can have a % adjustment applied to it. This is
done by clicking the 'MORE' button in the Project Window and
entering the % in the appropriate text field. When reports with
the option 'Include Markups' ticked are printed, all prices for
items with CC's defined are marked up by the % stated.
SubCategories:
In
addition to breaking down the price into Cost Categories, each
Cost Category can be further subdivided into up to 6
SubCategories. Each of these SubCategories can have their own
%adjustment as well.
Define the Subcategories and their appropriate '% adjustment'
values by clicking the 'Define SubCategories' button in the
'MORE' options of the Project Window.
NOTE: You
must tick the option 'Use Subcategory Markups' if you want the
reports to use these markups - if not ticked, the program will
use the %Adjustments as defined against each of the Cost
Categories.
Missing Resources:
If ever you unwittingly remove resources
from within the Resource Library that are contained within your
Estimate, under certain scenarios you can restore them back
into the Resource Library by following the steps outlined under
each of the scenarios listed below.
Scenario 1: You have been using
an external library as their source
- Open one of the Rate/Cost workup sheets, and make sure that
the external library is selected
Here is an example of 'The Control Project' being selected
- If it is not selected, then click the appropriate button and
select it
If a missing resource is found, it will look in this external
library for it and import it if it does exist
- Select the option 'Project->Recalculate'
This will close any worksheets currently open and start the
process
- Click 'Recalculate'
This will Recalculate the project, importing any missing
resources that exist in the selected external library
Scenario 2: The
resources were created in this Project
- Select the option 'Project->Recalculate'
- Click the button 'Automatically add non-existent
resources'
- Click 'Recalculate'
This will Recalculate the project, adding into the Resource
Library any missing resources
NOTE: Any
composites that were created
in a Rate/Cost workup sheet will be added into the
library together with it's rate build up. Any composites created in the Resource Library
will not be added as their will exist no detail of it's rate
build-up.
